Procurement cost control

Indoor Playground Equipment Price vs Landed Installed Cost: A Buyer Cost Map

The equipment quotation is only one layer of the opening budget. A useful comparison follows the same approved scope from factory price through freight, import, site preparation, installation, inspection, handover, spares, and early operating readiness.

Indoor playground packing and shipping used to explain landed installed cost
Vabibo presentation material · final costs depend on project scope and destination
Ideal starting point for
FEC investors and operatorsImporters and distributorsGeneral contractorsFinance and procurement teams
Direct answer

What project buyers need to know

Indoor playground equipment price covers only the quoted equipment and stated options. Landed cost adds packing, freight, insurance, import, brokerage, destination handling, and delivery to the agreed point. Installed cost adds site preparation, unloading, storage, local works, labor, tools, travel, assembly, and checks. The opening budget may also include approvals, inspection, training, spares, operating setup, and contingency. Compare suppliers on one scope and one responsibility matrix.

Key takeaways

  • Never compare headline totals built from different plan revisions or attraction scopes.
  • Define the delivery point and trade term before calling a price landed.
  • Assign site work, labor, tools, travel, inspection, and corrections before calling a price installed.
  • Keep opening costs and lifecycle allowances visible outside the equipment quotation.
  • Request a sensitivity table for design, material, schedule, freight, and installation changes.
Real process evidence

Cost evidence should follow the physical project

These Vabibo process images show where commercial assumptions become physical responsibilities. The photographs do not establish a universal price. Buyers should connect each cost line to the approved project, destination, party, quantity, document, and timing assumption.

Indoor playground material selection affecting equipment price
Equipment scope — component construction, finishes, activity mix, custom details, and replaceability affect the quoted package.

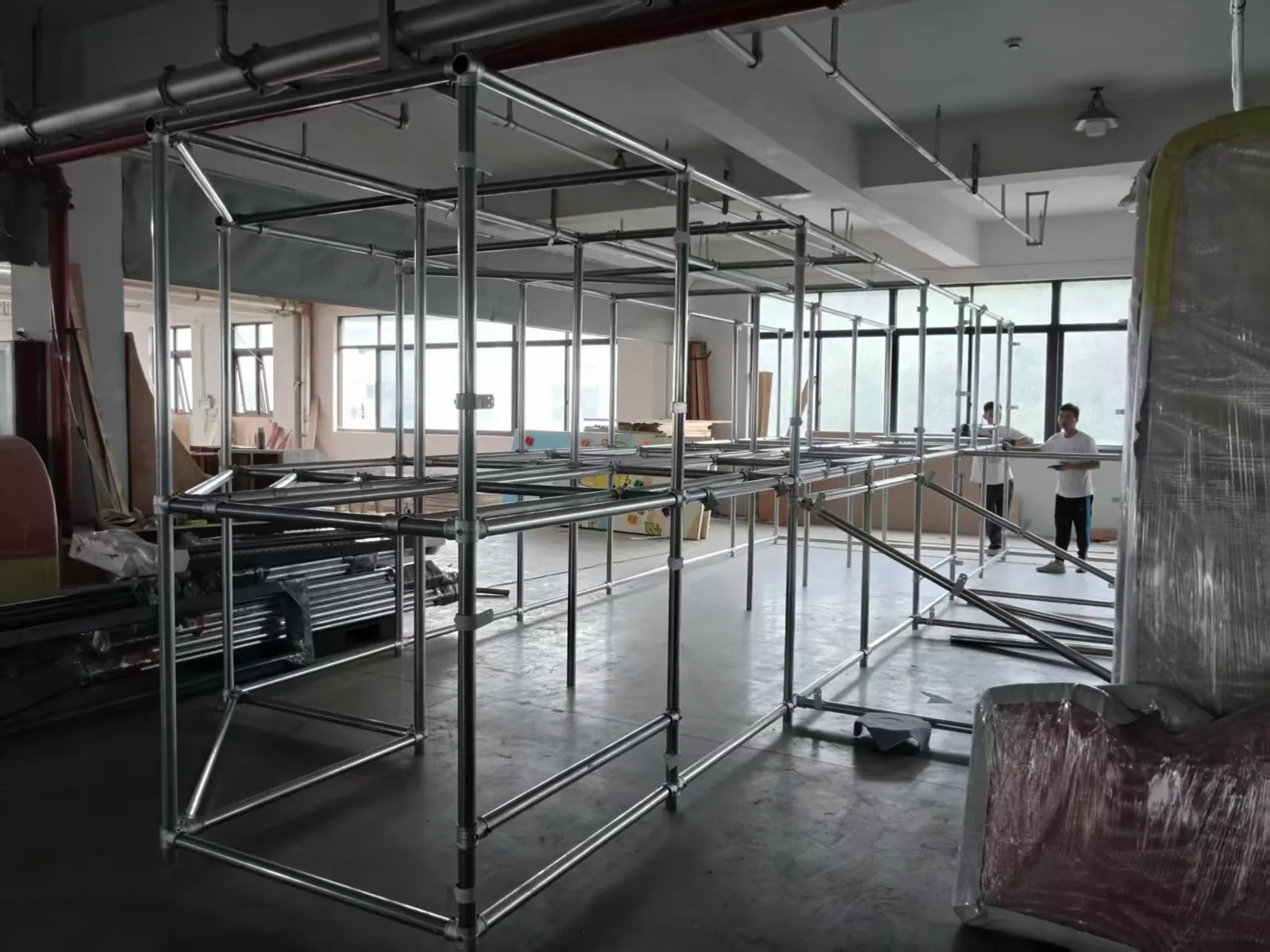

Indoor playground pre-assembly affecting inspection and correction cost
Pre-shipment control — trial assembly and closure of findings can reduce unresolved work after arrival when included in scope.
Indoor playground export packing affecting freight and landed cost
Logistics scope — package volume, protection, loading, trade term, route, and destination handling shape landed cost.

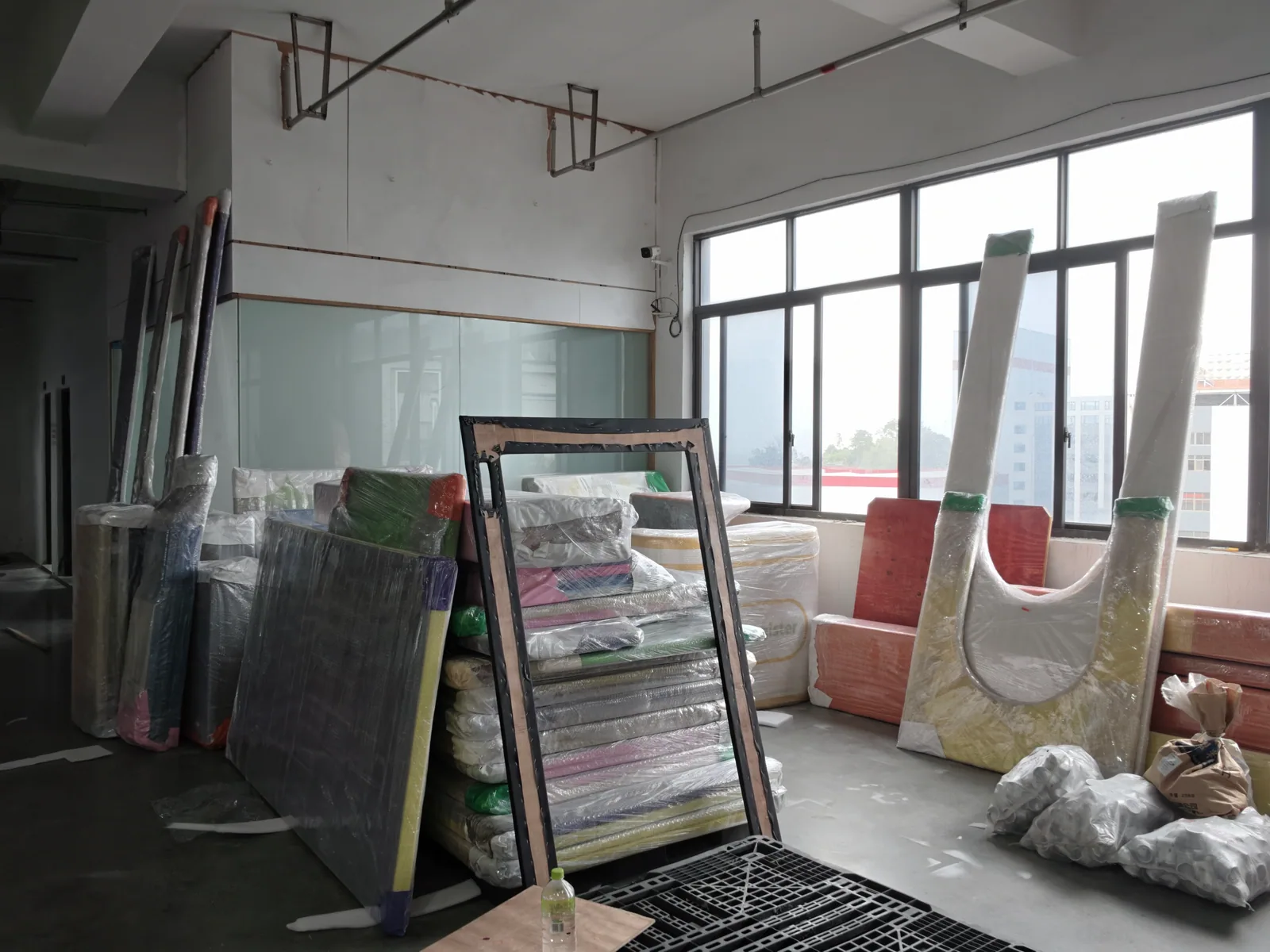

Indoor playground project detail affecting installation and handover cost
Installed scope — site interfaces, assembly sequence, local labor, tools, checks, corrections, and handover must be assigned.

Start with four separate cost layers

Use separate subtotals for equipment price, landed cost, installed cost, and total opening budget. This prevents a factory quotation from being mistaken for the amount required to open the venue.

Cost-layer definitions must be written into the comparison
Cost layerTypical componentsKey control question
Equipment priceQuoted play equipment, selected options, customization, stated documents, export packingDoes every supplier price the same approved plan, equipment schedule, material basis, and options?
Landed costEquipment plus freight, insurance, import, duty, tax, brokerage, terminal and destination deliveryWhat is the exact trade term and named delivery point, and which destination charges remain excluded?
Installed costLanded scope plus site work, unloading, storage, labor, tools, travel, supervision, assembly and checksWho supplies every local resource and who pays for delays, corrections, and missing items?
Opening budgetInstalled attraction plus approvals, inspection, operating setup, training, initial spares, marketing and contingencyWhat else must the owner fund before the venue can operate?

1. Normalize the equipment scope before comparing price

Confirm the same drawing number, revision date, equipment schedule, dimensions, clear height, age zones, capacity assumptions, activity mix, theme scope, material schedule, documents, spare parts, and quoted options. Mark every line as included, excluded, optional, allowance, or buyer responsibility.

A supplier may lower the total by reducing activity density, changing a slide or obstacle, simplifying graphics, substituting materials, excluding documents, or moving installation work to the buyer. These changes may be reasonable, but they must remain visible.

  • Base equipment and separately priced activities or technology
  • Custom theme, graphics, façade, lighting, interactive elements, and branding
  • Material construction, finishes, color references, and replaceable parts
  • Drawings, calculations where required, reports, manuals, labels, and inspection records
  • Export packing, package labels, initial spares, special tools, and exclusions

2. Control currency, trade term, payment, and schedule assumptions

Record the quotation currency, exchange-rate assumption, tax basis, price validity, trade term, named place, deposit, progress payments, balance-release evidence, and treatment of changes. A low price with an early balance payment and weak pre-shipment evidence may create more buyer risk than a higher staged proposal.

Separate design approval time, technical confirmation, production, inspection, packing, transit, customs, site readiness, installation, correction, and final inspection. A factory production estimate is not an opening date.

3. Build landed cost to one named destination point

Ask the freight forwarder or responsible supplier to identify export handling, packing assumptions, package volume and weight, freight, insurance, documentation, duty classification, tax, brokerage, port or terminal charges, demurrage exposure, inland delivery, and exclusions. Use one quotation date because freight and exchange assumptions can change.

Logistics lineEvidence to requestCommon comparison gap
Export packingPacking method, package list, dimensions, weights, labels and protectionPacking is included but crates, special protection, or installation sequence labels are not
International freightRoute, mode, equipment type, validity, surcharges and insurance basisOne quote includes current freight while another uses an allowance or excludes surcharges
Import and destinationClassification assumption, duty, tax, broker, terminal, inspection and delivery pointTaxes, port charges, exams, demurrage, or final delivery are omitted
Arrival handlingVehicle, unloading, lifting, access, storage, receiving checks and responsible teamThe shipment reaches the site but no party owns unloading or protected storage

4. Add every site and installation responsibility

Installed cost depends on site readiness, access, local construction, power, lighting, flooring, fire or building interfaces, unloading, storage, labor rates, installer travel, tools, lifting, supervision, installation drawings, inspection, punch-list correction, and schedule coordination.

Define whether the supplier provides a full installation team, one supervisor working with local labor, remote guidance, or drawings only. Record working hours, visas, flights, accommodation, local transport, insurance, site induction, overtime, delays, return visits, and who corrects site or equipment issues.

Installed does not mean ready to open unless final checks, required inspection, operator records, training, spares, and outstanding-item closure are also assigned.

5. Price documents, inspection, and corrective work

Required reports, calculations, drawings, translations, labels, third-party inspections, local professional review, and final site inspection may sit outside the equipment quotation. Identify the responsible party, document holder, product scope, timing, language, acceptance criteria, and correction process before supplier selection.

Create an allowance for unresolved requirements instead of assuming they will be free. When a document cannot apply to the ordered configuration, record the replacement plan and commercial impact.

6. Keep opening and lifecycle allowances visible

The owner may still need furniture, café or party-room fit-out, POS and access control, staffing, training, insurance, signage, cleaning equipment, maintenance tools, marketing, initial consumables, replacement covers, high-wear spares, and working capital. These costs do not belong in every supplier quotation, but they belong in the investment decision.

Compare warranty logistics as well as duration. Ask who diagnoses a problem, what evidence is required, whether labor and freight are included, where parts ship from, and what the venue does while waiting.

7. Build a normalized quotation comparison

Use one spreadsheet or responsibility matrix with rows for every equipment, logistics, site, installation, document, inspection, handover, and contingency line. Keep supplier price, buyer allowance, unresolved risk, responsible party, evidence reference, and timing in separate columns.

Comparison columnWhat to recordWhy it matters
Controlled scopePlan revision, equipment schedule, material basis and optionsPrevents comparison of different attractions
Supplier amountIncluded price, currency, tax basis, trade term and validityShows the commercial offer without hiding the basis
Buyer allowanceRealistic budget for excluded local or third-party workConverts exclusions into a comparable opening cost
Unresolved riskUnknown requirement, owner, deadline and possible cost rangeStops optimistic assumptions from appearing as savings
Evidence and gateRequired document or record and the release milestoneConnects payment and progress to proof

Decision rule: compare the expected opening cost and residual risk. Do not award a supplier for leaving a responsibility unpriced.

8. What to submit for a useful budget comparison

Send the current floor plan and clear-height map, country and delivery city, venue type, target ages and capacity, preferred attraction mix, theme direction, operating model, budget range, target opening date, site readiness assumptions, required standards and documents, preferred trade term, unloading conditions, and intended installation model.

Vabibo can separate the core equipment scope from options, identify missing cost inputs, and organize an initial landed-and-installed responsibility map. Final pricing still requires an approved configuration, current logistics basis, confirmed destination requirements, and agreed project responsibilities.

Sources and related references

This buyer guidance supports early planning. Final dimensions, standards, responsibilities, and approvals must be confirmed for the actual project and destination.

What this page covers

Build the proposal around the venue—not a fixed package

Every project combines design decisions, operating needs, technical constraints, and delivery responsibilities.

01

Compare one controlled scope

Give every supplier the same site information, activity brief, drawing revision, destination, and responsibility questions.

02

Connect claims to the order

Verify legal, technical, production, inspection, packing, and service evidence against the equipment actually quoted.

03

Price unresolved responsibility

Treat every exclusion, allowance, and unassigned task as a cost or schedule risk until an owner is recorded.

04

Release decisions in stages

Close high-risk gaps before shortlist, deposit, technical approval, shipment, installation, and final handover.

Planning priorities

Compare the cost to open, not the price to leave the factory

Two quotations can show similar equipment but assign freight, documentation, local work, installation, inspection, correction, and after-sales responsibilities very differently.

Prepare the Brief
  1. 01

    One approved drawing revision and equipment schedule

  2. 02

    Currency, tax basis, trade term, payment milestones, and validity

  3. 03

    Freight, insurance, duty, tax, brokerage, port, and destination handling

  4. 04

    Site preparation, access, unloading, storage, utilities, and local construction

  5. 05

    Installation labor, supervision, travel, tools, lifting, and inspection

  6. 06

    Handover records, initial spares, warranty logistics, and opening contingency

A practical path forward

Move from idea to coordinated decisions

The exact deliverables depend on the project, but the decision path remains clear.

01

Issue one brief

Release the same site, audience, attraction, standards, budget, delivery, and schedule information to every candidate.

02

Collect evidence

Request named records for the legal entity, project, design revision, materials, production, packing, and service scope.

03

Normalize the scope

Separate included work, options, allowances, exclusions, buyer responsibilities, and unresolved assumptions.

04

Approve the next gate

Record the owner, evidence, commercial effect, and deadline for every item required before the next commitment.

Frequently asked

Useful answers before the first design discussion

Final specifications, responsibilities, standards, and timing are confirmed against the actual project scope.

What is included in landed cost?+

Landed cost normally follows the shipment to an agreed destination point and may include equipment, export packing, freight, insurance, duty, tax, brokerage, port or terminal charges, and inland delivery. The exact definition depends on the quotation, trade term, country, and agreed delivery point.

Is installed cost the same as opening budget?+

No. Installed cost may include equipment, logistics, site preparation, labor, tools, travel, and assembly, but an opening budget may also require design and approval costs, local construction, inspections, permits, staff preparation, signage, POS systems, furniture, marketing, initial spares, and contingency.

Should I choose the lowest equipment quotation?+

Only after normalizing the same plan, activity scope, materials, documents, delivery point, installation responsibility, schedule, and after-sales assumptions. A lower equipment figure can still create a higher opening cost or a less controllable schedule.

Can Vabibo estimate cost from area alone?+

Area is an early feasibility input, not a final pricing method. Clear height, activity density, age mix, custom theme, materials, standards and documents, destination, packing, installation model, and project schedule can materially change the total.
